Data Center Power Infrastructure

Power Train Unit (PTU)

Prefabricated Modular Power Infrastructure for Data Centers

Build critical power capacity through standardized, repeatable power blocks that move complex integration work from the project site into a controlled factory environment.

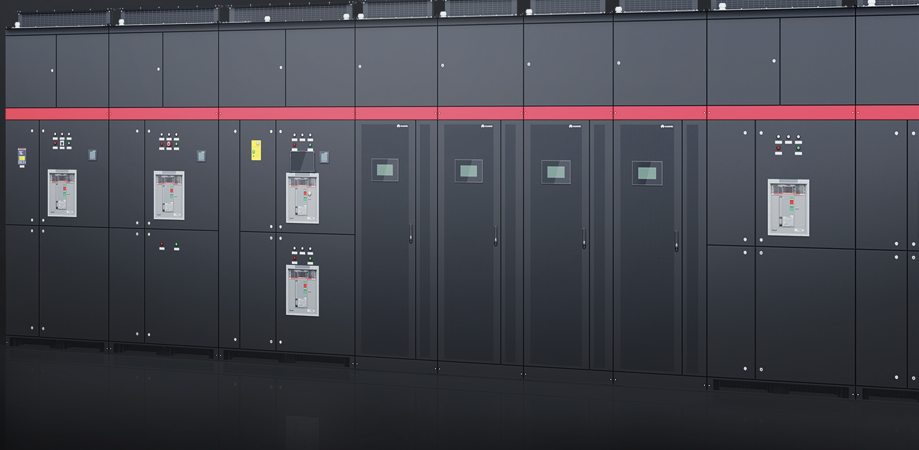

Power Train Unit PTU - Huawei PowerPOD FusionPower9000
Power Infrastructure as a Building Block

What Is a Power Train Unit?

A Power Train Unit transforms critical electrical infrastructure from a collection of separately constructed systems into a standardized, repeatable functional module.

Instead of installing and interconnecting every UPS, battery system, switchboard, control system and supporting component independently at site, a PTU moves a significant portion of system integration, testing and pre-commissioning into the factory.

The result is a more controlled delivery model that can help simplify site construction, standardize capacity blocks and support phased data center expansion.

Working Definition

A Power Train Unit (PTU) is a standardized and repeatable power-infrastructure building block that integrates a defined portion of the electrical power path and its supporting systems into a controlled functional module.

A PTU is not simply an UPS inside a container.

The container is only one possible physical form. The real design starts with the functional power boundary, capacity, redundancy and interfaces required by the data center.

Why Power Train Unit?

Simplify How Critical Power Is Designed and Delivered

PTU architecture converts major parts of the power infrastructure into repeatable engineered blocks, reducing reliance on large-scale site assembly.

01

Factory Integration

Move assembly, internal interconnection, inspection and pre-commissioning into a controlled production environment.

02

Faster Deployment

Allow module production and site preparation to run in parallel while reducing complex field installation activities.

03

Repeatable Capacity

Scale infrastructure by deploying standardized power blocks instead of repeatedly redesigning one increasingly large central power room.

04

Controlled Interfaces

Define clear boundaries between source, transformation, UPS, energy storage, distribution, monitoring and downstream loads.

Typical Architecture

From Source to Critical Load

The exact functional boundary varies by project. A complete power train can extend from the utility or generator interface to the final distribution feeding IT and critical mechanical loads.

01 · Source Utility / Generator
02 · Transformation MV System / Transformer
03 · Switching LV Switchboard / ATS
04 · Continuity UPS + Energy Storage
05 · Distribution Busway / Feeder System
06 · Load IT Rack / Critical Load

Transformer, MV equipment, generator, busway and other upstream or downstream equipment may be integrated, adjacent to the PTU, or provided separately depending on the approved project architecture and scope boundary.

Integrated Systems

More Than Power Conversion

A prefabricated power module combines the electrical path with the supporting systems required to operate the infrastructure as one engineered environment.

Power Supply & Distribution

Main input, switching, protection, bypass, UPS output distribution and feeder interfaces are engineered as part of the defined power path.

UPS & Power Continuity

Modular or parallel UPS architecture provides conditioned power continuity according to the required capacity and redundancy philosophy.

Energy Storage

Battery systems provide the required ride-through period and must be engineered around autonomy, end-of-life capacity, temperature and safety.

Thermal Management

Dedicated cooling maintains the internal environment within the operating limits of critical electrical and battery equipment.

Monitoring & Control

Electrical status, environmental conditions, battery health, alarms and subsystem data can be consolidated for local and remote monitoring.

Fire & Safety

Fire detection, suppression interfaces, emergency power-off, access and safety systems are coordinated with the project fire strategy and local requirements.

Huawei PowerPOD

Designed Around Reliability, Agility and Efficiency

RELIABLE

Integrated System Reliability

Power architecture, enclosure, battery, monitoring, cooling and safety systems are engineered as part of one coordinated module.

AGILE

Factory Prefabrication

High factory integration reduces field assembly and allows more testing and pre-commissioning to be completed before delivery.

FLEXIBLE

Phased Capacity Expansion

Repeatable power blocks support staged deployment so electrical infrastructure can be aligned with actual data center capacity growth.

SUSTAINABLE

High-Efficiency Power Path

Efficient UPS operation and busbar-based distribution are designed to reduce losses across the complete power path.

Technical Overview

Huawei FusionPower9000 Reference Configuration

Final configuration must be selected against the approved project load, redundancy, battery autonomy, environmental conditions and system architecture.

Product Type Outdoor integrated power supply and distribution solution
Typical Application Medium and large data centers, high-density and phased deployment
Module Concept One power system per container
Reference Input Capacity Up to 2.4 MVA per module
System Voltage 380 V / 400 V / 415 V AC
Reference Container Size 12,192 × 3,495 × 4,150 mm
UPS Platform Huawei UPS5000-H modular UPS
UPS Architecture Multiple parallel UPS configurations according to IT and mechanical load requirements
Energy Storage Huawei SmartLi lithium battery system; capacity and autonomy project-specific
Cooling Integrated dedicated cooling with redundancy options according to project design
Monitoring ECC800-Pro local management with remote monitoring and upstream integration options
Outdoor Protection IP55 reference enclosure protection
Structural Reference Zone 3 seismic resistance and Grade 12 wind resistance
Fire & Safety Integrated detection, EPO and fire suppression provisions subject to local code and approved fire strategy

Technical values above represent reference Huawei FusionPower9000 configurations. Actual capacity, topology, component selection, redundancy and performance depend on the project-specific design and latest OEM documentation.

Deployment Scenarios

Built for Different Data Center Strategies

New Data Center Development

Standardize power blocks from the beginning and align electrical infrastructure deployment with the planned data hall rollout.

Data Center Expansion

Introduce additional capacity through repeatable modules where the site architecture supports phased expansion.

AI & High-Density Infrastructure

Address rapid capacity growth, limited internal building space and tighter project deployment schedules.

Outdoor Power Infrastructure

Decouple selected electrical infrastructure from the primary data center building and preserve valuable indoor space.

NPS Integration Approach

From PowerPOD to a Complete Power Train

Selecting the module is only one part of the project. The PTU must be integrated with the complete upstream and downstream electrical architecture.

01 Requirement Review

IT load, rack density, redundancy, battery autonomy and expansion targets.

02 Architecture & Boundary

Define source, transformer, generator, PTU, busway and rack-distribution responsibilities.

03 Solution Configuration

Select capacity block, UPS architecture, battery, cooling, monitoring and redundancy.

04 Delivery & Commissioning

Coordinate site readiness, installation, interconnection, testing and commissioning.

05 Lifecycle Support

Maintenance planning, troubleshooting, system assessment and technical support.

Why Choose NPS?

Power Infrastructure Designed Around the Complete System

01

Requirement-Based Design

We start with actual load, redundancy, site condition, source strategy and future expansion—not only equipment selection.

02

End-to-End Power Integration

NPS coordinates the interfaces between upstream source systems, PTU, busway, critical loads, controls and monitoring.

03

From Supply to Commissioning

Support covers technical review, delivery coordination, installation interfaces, testing, commissioning and handover.

04

Lifecycle Technical Support

Critical infrastructure requires maintenance, troubleshooting and technical coordination long after initial project completion.

Frequently Asked Questions

Power Train Unit FAQ

What is a Power Train Unit in a data center?

A Power Train Unit is a standardized functional building block that integrates a defined portion of the critical electrical power path and supporting systems. Depending on project scope, this may include switching, UPS, battery, distribution, cooling, monitoring, safety systems and associated interfaces.

Is a PTU the same as a containerized UPS?

No. A UPS is one equipment within the power path, while a PTU is a system-level building block. A container is only one possible physical implementation of that system.

Does every PTU include a transformer and generator?

Not necessarily. Transformer, MV switchgear and generator systems may be inside the defined power train, located adjacent to the module, or supplied separately. The boundary must be established during project design.

Can a PTU support phased data center expansion?

Yes. One of the primary advantages of a modular PTU architecture is the ability to deploy repeatable capacity blocks according to the approved expansion strategy and site design.

Is Huawei FusionPower9000 always configured at 2.4 MVA?

No. 2.4 MVA represents a reference maximum capacity for the current platform configuration. Actual usable capacity depends on UPS arrangement, redundancy, IT and mechanical load allocation, battery design and project requirements.

Plan Your Power Architecture

Discuss Your Power Train Unit Requirement

NPS can review your IT load, redundancy, battery autonomy, source architecture, distribution strategy, deployment constraints and expansion plan before defining the final PTU configuration.
